Skip to content

The New Connector Fits. Does the Evidence?

By

Oct 15, 2026

One connector half has changed. Here is what UQD v2 testing can tell you about the new pair, and what still needs checking.

Two separated metallic liquid-cooling connector halves, facing each other.
One connection. Two part histories.

A replacement quick disconnect plug arrives for a cooling branch. It is the right nominal size, clearly marked UQD04 v2, and clicks into the socket that has been in the rack since commissioning. The joint stays dry. So far, so good.

But the socket has not changed, and its history matters just as much as the new plug's. Before returning the branch to service, the team still needs to know whether these two parts have been tested together, whether the valves are fully open and whether the branch returns to its accepted flow and pressure.

That is where a reassuring word like "compatible" can hide several different questions. The Open Compute Project's Universal Quick Disconnect specification helps separate them. Its testing has clear boundaries, especially when a new half meets an older one.

First, find out what was actually tested

UQD v2.0.0 took effect on September 22, 2026. It covers handmate UQD connectors, blindmate UQDB connectors and the hybrid of a UQD plug blindmated into a UQDB socket, in single-phase water and glycol cooling loops. It sets the interface dimensions and the performance that every supplier's parts must meet, so that parts from different suppliers can work together.

There are two kinds of test evidence. The names sound similar, but they answer different questions (sections 9 and 10).

Two kinds of v2 evidence

Supplier verification

Who tests
Each supplier, on its own plugs and sockets
Tests
Burst, fluid loss, force to connect, pressure drop and seal washout, then shipping and operating temperature cycling, 5,000 coupling cycles and hydrostatic leak checks
Samples
At least 5 per test
Where to find it
Report on request; part of an OCP Marketplace listing

Supplier cross-verification

Who tests
Each supplier, with at least 3 other suppliers
Tests
Fluid loss, force to connect, pressure drop and seal washout
Samples
At least 3 per test
Where to find it
Published list of suppliers whose parts passed; reports on request

Neither covers a pair that mixes v1 and v2 parts. Source: UQD v2.0.0, sections 9 and 10.

The important distinction is what is missing from the mixed-pair test. Cross-verification does not include burst testing or the longer thermal and mechanical sequence. Those results come from each supplier's own verification, using its own parts.

Section 6.1 says version 2 is designed to be backwards compatible with the earlier, separate version 1 specifications for UQD and UQDB, and it encourages end users to assess their own deployments. Section 10 is explicit that cross-verification across versions is not in scope. Differences in performance, features or dimensions "should be evaluated by the end user when considering mixed version deployments."

In other words, a list of approved suppliers is not a blanket approval for every combination of their parts. A v2 plug on a v1 socket sits outside the required v2 cross-verification, even if both suppliers appear on each other's lists. Choose a pairing below to see what evidence to request.

Evidence scope

Which document covers which test?

Choose a pairing. See the evidence to request before a replacement goes into service.

Pairing in the branch
Socketv2Retained half
Plugv2Replacement half

Supplier verification

Request the report for these parts.

The supplier tests its own plug and socket. Check identities and configurations against the report.

Socketv2Retained half
Plugv2Replacement half

Four cross-verification tests

A listing is not the report.

Fluid loss, connection force, pressure drop and seal washout. Confirm the named parts in the report.

Socketv2Retained half
Plugv2Replacement half

Pair evidence still open

Ask both suppliers.

The v2 marking describes each half. It does not establish that this particular combination was tested.

Socketv1Retained half
Plugv2Replacement half

Outside v2 cross-verification

A new pairing needs its own review.

The required cross-verification does not cover a v1/v2 combination. Check the mixed-version guidance.

Socket?Retained half
Plugv2Replacement half

Identify the retained half

Do not infer a version from fit.

Record supplier, part number, revision and version before choosing the applicable evidence.

See all eight evidence checks
v2 interface and marking
Supplier evidenceEach half is built to v2 dimensions and marked v2.
Supplier evidenceEach half is built to v2 dimensions and marked v2.
Supplier evidenceEach half is built to v2 dimensions and marked v2.
Outside scopev1 did not define plug end, overall length or outside diameter.
Identify firstMarking missing or unreadable. Record the version as unknown.
Burst pressure
Pair report neededPlug, socket and mated pair, in the supplier report.
Supplier evidenceNot in cross-verification. Each supplier tested its own pair.
Supplier evidenceEach supplier tested its own pair, not this one.
Supplier evidenceEach half has only its own version's evidence.
Identify firstTreat as a mixed-version pair until both halves are identified.
Fluid loss
Pair report neededRequest the supplier's report for the named parts. At least 5 samples per test.
Pair report neededRequest the cross-verification report for the named parts. At least 3 samples per test.
Outside scopeNo published cross-verification. Ask both suppliers.
Outside scopeOutside v2 scope. A v1 plug tip with little chamfer may damage socket seals.
Identify firstTreat as a mixed-version pair until both halves are identified.
Force to connect
Pair report neededRequest the supplier's report for the named parts. At least 5 samples per test.
Pair report neededRequest the cross-verification report for the named parts. At least 3 samples per test.
Outside scopeNo published cross-verification. Ask both suppliers.
Outside scopeOutside v2 scope. Some v1 sets may not couple fully.
Identify firstTreat as a mixed-version pair until both halves are identified.
Pressure drop (water, 25 °C)
Pair report neededRequest the supplier's report for the named parts. At least 5 samples per test.
Pair report neededRequest the cross-verification report for the named parts. At least 3 samples per test.
Outside scopeNo published cross-verification. Ask both suppliers.
Outside scopeOutside v2 scope. A v1 pair may have a lower Cv and a higher drop.
Identify firstTreat as a mixed-version pair until both halves are identified.
Seal washout
Pair report neededRequest the supplier's report for the named parts. At least 5 samples per test.
Pair report neededRequest the cross-verification report for the named parts. At least 3 samples per test.
Outside scopeNo published cross-verification. Ask both suppliers.
Outside scopeOutside v2 scope for a mixed pair. The end user evaluates.
Identify firstTreat as a mixed-version pair until both halves are identified.
Thermal and mechanical cycling, 5,000 couplings
Pair report neededThe supplier's own sequence, run on its own parts.
Supplier evidenceNot in cross-verification. Each supplier's own parts only.
Supplier evidenceEach supplier's own parts only.
Outside scopeOutside v2 scope for a mixed pair.
Identify firstTreat as a mixed-version pair until both halves are identified.
Your coolant, temperature and installation
Site evidenceComponent reports do not establish site acceptance. Pressure-drop testing uses water at 25 °C.
Site evidenceComponent reports do not establish site acceptance. Pressure-drop testing uses water at 25 °C.
Site evidenceComponent reports do not establish site acceptance. Pressure-drop testing uses water at 25 °C.
Site evidenceComponent reports do not establish site acceptance. Pressure-drop testing uses water at 25 °C.
Site evidenceComponent reports do not establish site acceptance. Pressure-drop testing uses water at 25 °C.

A supplier listing is a starting point. Confirm that the actual report names both parts. Based on UQD v2.0.0, sections 9 to 11 and appendix 15.1.

The older half deserves a closer look

The specification's appendix lists what to consider when v1 and v2 parts are mixed. It is reference material, not a requirement, but it reads as a precise checklist (appendix 15.1):

  • Plug tip. Version 1 did not define the plug end condition. A v1 plug with little or no chamfer may damage the seals of both v1 and v2 sockets.
  • Length and diameter. Version 1 did not define overall length or maximum outside diameter, so a v1 part may need the original panel spacing and pitch.
  • Flow. Version 2 raised the minimum flow coefficient. A v1 pair may have a higher pressure drop across its valves than a v2 pair.
  • Coupling. Version 1 set only a minimum valve stroke, and tolerance stacks in the internal valving could stop some v1 sets from coupling fully.
  • Blindmate tolerance. v1 UQDB systems without built-in tolerance compliance may see variation in coupling panel distance and in flow. Version 2 replaces the minimum engagement requirement with guidance to ensure full coupling at the hard-stop.

A dry joint can still restrict flow

The seal and the valves do different jobs. A seal can keep coolant inside while a partly opened valve still makes it harder to pass through. That is why looking for a leak cannot replace checking full engagement.

In a non-spill quick disconnect, each half contains a valve, and the valves open as the halves engage. CPC's flow dynamics guide explains that for blindmate couplings the connected length directly affects pressure drop, because the valves can sit anywhere between full flow and full shutoff. It recommends an axial tolerance window that suits the system.

UQD v2 measures blindmate and hybrid pairs at the fully mated hard-stop. A pair that stops short of the hard-stop is outside the condition its pressure-drop result describes, even if it is dry.

The cutaway below separates those two events. Its stroke scale explains the sequence, not the dimensions or valve travel of a particular product. Compare full engagement with a connection that stops early.

Valve engagement

Dry is not the same as fully open

Watch the seal close before the valves fully open. Then compare a pair that stops short.

Compare full engagement with a pair that stops short. Both are sealed, but their valve openings differ.

This pair
Socket Retained halfPlug Replacement half
Schematic coupling stroke of a non-spill quick disconnect A socket on the left and a plug moving in from the right. Each half has a spring-loaded valve. Cyan shows coolant; it crosses the joint only once the valves open. Not fully seated
Metal housingCoolant pathSeal
Engaged0%of full stroke
Valves0%open
OutsideApartno seal yet
Apart

Apart. Both valves are closed. Nothing flows and nothing leaks.

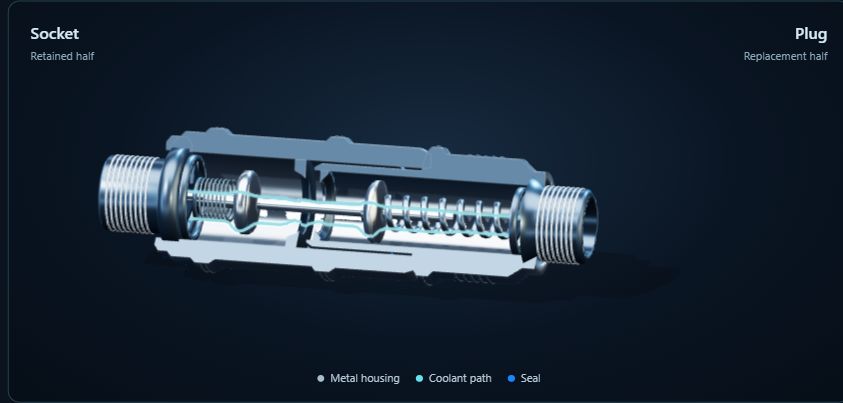

Fully engaged

Sectional coupling at full engagement. Both valves have moved off their seats and the coolant path is open.

At the hard-stop, both valves are fully open.

Stopped short

Sectional coupling stopped before the shoulder reaches the hard-stop. The seal is engaged, but the valves have less travel.

The seal has engaged, but the valve opening is restricted.

The seal closes before the valves finish opening. Confirm full engagement under the equipment procedure.

Read the pressure-drop result with its conditions

Outside size says little about flow. CPC's guide states that external connector dimensions are not a good indicator of flow coefficient. UQD v2 sets a flow-coefficient band for each size (Table 6) and defines how pressure drop is measured (section 9.1.4):

  • water at 25 °C, within 5 °C either way
  • at least six flow rates from 25 to 150 percent of the size's rated flow
  • each flow direction, with the test fittings' own loss subtracted
  • a fitted curve P(Q) = AQ² + BQ, with P in psi and Q in liters per minute, plus the drop at 100 and 150 percent of rated flow
  • the minimum flow coefficient, Cv, at rated flow in both directions

Cv is the flow in US gallons per minute that gives a 1 psi drop with water. The specification notes that it is reported relative to water: for other coolants, apply correction factors or test further. A glycol branch at operating temperature is not the test condition.

Put numbers to it. For a size 04 pair at its rated flow of 6.44 liters per minute, the v2 range of Cv 1.1 to 1.6 gives roughly 1.1 to 2.4 psi (0.08 to 0.16 bar) with water. This calculation uses constant Cv; it is not a supplier's measured test curve.

A branch with a supply and a return connector carries two such pairs, alongside filters, manifolds and bends that the CPC selection guide also asks designers to count. Our April article on pressure budgets shows how quickly losses like these use up a rack's allowance.

Flow and pressure

A smaller flow path costs more pressure

Move the flow slider. Compare a lower-Cv pair with the v2 Cv range.

Compare the calculated pressure range for size 04 with a lower-Cv pair. Open the values below for every size.

Connector size
Compare at
Connectors in the branch
v2 band at this flow1.1 to 2.4 psi
Hypothetical pair3.7 psi
Same pressure drop80% of the flowfor the hypothetical pair
Ready

Calculated pressure drop for one size 04 pair with water and constant Cv. The range is 1.1 to 2.4 psi at the rated 6.44 liters per minute, and 2.5 to 5.4 psi at 150 percent. A dashed hypothetical pair at 80 percent of the minimum Cv sits above the range. These are not measured supplier curves.
Calculation, limits and values for every size

Pressure drop for one coupled pair, one flow direction, with water: drop in psi = (flow in gpm / Cv) squared. Cv bands and rated flows are from UQD v2.0.0, Table 6. Real results are fitted as P(Q) = AQ² + BQ and differ by direction and by part. The hypothetical pair is an example of a lower Cv, such as appendix 15.1 warns a v1 pair may have. It is not a published value. Glycol and other temperatures need the supplier's correction or further testing.

Scroll the table sideways on smaller screens. Keyboard: focus the table, then use the arrow keys.

v2 rated flow, Cv band and calculated pressure drop for one coupled pair with water and constant Cv
SizeRated flow, L/min (gpm)v2 Cv, max to minDrop at rated flowDrop at 150%
022.27 (0.60)0.43 to 0.31.9 to 4.0 psi
0.13 to 0.28 bar
4.4 to 9.0 psi
046.44 (1.70)1.6 to 1.11.1 to 2.4 psi
0.08 to 0.16 bar
2.5 to 5.4 psi
0611.36 (3.00)3.3 to 2.20.8 to 1.9 psi
0.06 to 0.13 bar
1.9 to 4.2 psi
0817.79 (4.70)5.6 to 3.60.7 to 1.7 psi
0.05 to 0.12 bar
1.6 to 3.8 psi
Calculated with water and constant Cv. The specification requires at least six measured flow points; it does not prescribe these six settings.

Now lower Cv by 20 percent from the v2 minimum. Holding the same flow takes about 56 percent more pressure drop. Holding the same pressure drop instead delivers 20 percent less flow. Switch between the two views above to see the trade-off. The specification gives no v1 Cv value, so the 20 percent reduction is an assumed comparison, not a claim about a particular v1 part.

Record both halves when one changes

Replacing just the plug creates a new pairing. The record needs both identities, not just the part number on the delivery note. It should also show which evidence covers the pair and what happened when the branch returned to service.

RecordWhy it matters
Both halves: supplier, part number, revision, size, configuration (handmate, blindmate or hybrid) and terminationA report covers named parts, not a connector family or a size
The marked version of each half, or "unknown"A mixed-version pair is outside the required v2 scope; an unknown version leaves that scope unconfirmed
The evidence for this pair: a verification report reference, the cross-verification list entry, or a mixed-version assessmentEach document covers a different set of tests
How full engagement was confirmed under the equipment procedurePressure-drop results describe a fully coupled pair
Coolant and temperature in the branchv2 results are for water at 25 °C
Flow and pressure at the same points before and after the changeShows whether the branch returned to its accepted condition

If the branch is drained and refilled, note how flow was introduced. The specification warns that in open-loop filling, extreme pressure drop and line velocity across a UQD valve set can wash a valve seal out of its gland, so fill and drain should bring in flow and pressure progressively, within ratings (section 9.1.5).

A missing report is not a failed test, and a report for a different pair is not a failed test either. Both are open questions to settle with the supplier before the substitution is approved. Isolation, draining, reconnection, refilling and return to service belong to the equipment instructions and the site's authorized procedure.

A better question for the supplier

Instead of asking whether a connector is compatible, send both identities and the intended use:

We plan to keep this socket (supplier, part number, revision, marked version) and install this plug (same details) in a handmate, blindmate or hybrid connection carrying our coolant at our operating temperature and flow. Please send the verification or cross-verification report that covers this exact pairing, or confirm that none exists. If the halves are different versions, tell us what has been evaluated for this combination.

A useful answer names a document and the parts it covers. If that evidence is missing, keep the question in the change review. The next shift should not have to guess what "compatible" meant.

Where Reliability Engine fits

Component documents describe what a pair did on a test bench. After a change, the open question is what the installed branch is doing. Reliability Engine's Virtual Chemist brings coolant condition, loop telemetry such as flow, temperature and pressure at rack inlets and outlets, and available GPU context into one view, so a team can check whether a branch returned to its accepted condition after an intervention like a connector replacement.

It does not certify connector pairs, approve substitutions or replace supplier reports and site acceptance. To track branch evidence through maintenance changes, talk to Reliability Engine.

Subscribe to updates

Get the latest engineering perspectives sent straight to your inbox.

References

  1. Open Compute Project: Universal Quick Disconnect (UQD) Design Specification v2.0.0, effective September 22, 2026. Sections 6.1, 8, 9, 10 and 11, and appendix 15.1.
  2. CPC: Why Fluidic Flow Dynamics Are Critical to the Design of High-Performance Electronics, 2023. Pages 5 and 6.
  3. CPC: The ABCs of Quick Disconnects, Part 2, 2025. Flow rate and system pressure drop.
  4. Reliability Engine: Understanding Pressure Drop in Liquid Cooling, April 22, 2026.
  5. Reliability Engine: Virtual Chemist, product page, read October 11, 2026.
